APPENDIX
A
TTP
for Clearing and Verification
The
TTP for the separation of forces and establishment of the ZOS was jointly developed
by the FWF leaders at the brigade's first JMC.
Aside

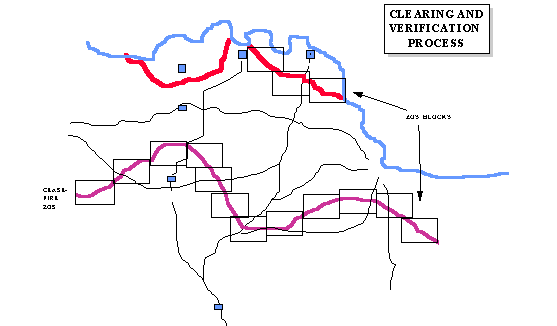

from designation of the actual ZOSs, one of the first control measures that
was established was the ZOS blocks. The ZOS blocks allowed the TFE to track
the progress of separation and establishment of the ZOS.

The
first priority was to ensure freedom of movement. The TFE and FWF would accomplish
this by "punching holes" through the ZOS which entailed clearance of major
routes. Once this was complete, the TFE and FWF could focus their efforts on
separation of forces and other requirements of the GFAP.
METHOD:

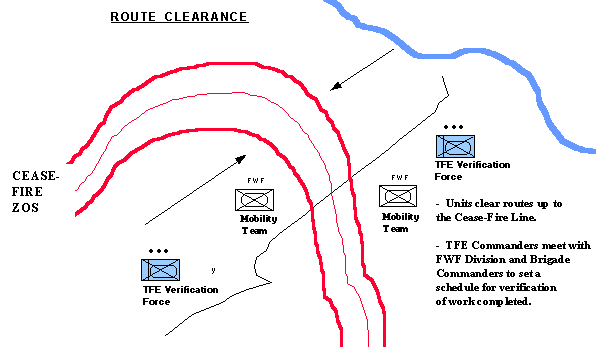

- TFE
commanders continue to meet with FWF leaders and verify clearing of major roads
in the ZOS.
- TFE
units report route reconnaissance and route status daily.
- TFE
verifies FWF perform the clearing.
- TFE
does not provide full-time escort to forces performing the work to clear routes,
but verifies the work.
- Simultaneous
clearing from both sides of the ZOS.
- All
major routes must be cleared within the first week of operations.
- Clear
Routes were defined by the following:
- Areas
cleared up to 50 meters on either side of the road (300 meters on the major
MSR).
- Bunkers
along sides of road are dismantled.
- All
wire and mines cleared along the road and up to 50 meters on either side.
- All
unexploded ordnance cleared along the road and up to 50 meters on either side.
|
METHOD
Section
V: Controlling the ZOS
Appendix
B: TTP for ZOS Breaching
