CHAPTER 4

How the E-BFV-Equipped Engineer Company Can Support
Defensive Missions for the Three-Company Battalion

by MAJ Michael Albertson, Center for Army Lessons Learned


During NTC Rotation No. 98-10, observer/controllers (O/Cs) spent some time discussing and identifying suitable roles and missions for units and attachments that will support the Army XXI three-company battalion. During previous rotations, when rotating battalions executed a defensive mission, it was not uncommon for a company team, with the scout platoon attached, to occupy positions well forward of the main battle area and establish a counter-reconnaissance screen. This permitted the remaining three company teams to prepare the defensive framework for the task force in a secure environment. With attached engineer support, the three companies could ensure that their battle positions were mutually supporting and achieve interlocking sectors of direct fire weapon systems into a task force engagement area (EA).

With the smaller three-company organization, the concept of interlocking sectors of fire is difficult to achieve with adequate mass. If one company team is positioned forward to conduct the counter-reconnaissance mission, that only leaves two company teams to develop the defensive framework for the task force. It is difficult to achieve "mutual support" between battle positions with two company teams. More two-company engagement areas may emanate as a result of the new three-company organization.

Also as a result of the new task organization, some O/Cs at the NTC believe they will see more "mobile defenses" in the future. This will translate into the execution of more delays, and possibly ambushes at the company team level, to disrupt, shape, and attrit any approaching enemy. It will be critical to disrupt the enemy to slow his forward momentum early in his approach, before the direct fire engagement.

There will be fewer weapon systems available, and, for this reason, it becomes extremely important to rehearse tactics and techniques for massing the effects of all available direct fire weapons. The reduced combat power will also require the task force to rely on the factors of careful time and space management, to decisively engage an approaching enemy. The technological enablers, in the form of greater situational awareness gained through a reconnaissance in depth of the attacking enemy, will be critical for success.

The role of the tactical reserve is likely to change. It is very unlikely that an Army XXI task force can maintain a company team-sized reserve. If a task force maintains a reserve, it will very likely be a platoon-sized force. Because massing available combat power at precisely the right time and place will be critical for defensive victory, units under the Army XXI framework will be required to exercise greater flexibility than did the units in the Army of Excellence model. Because a reserve force may not be possible, units will most likely execute more "be prepared" and more "on order" movement instructions. In this fluid environment, flexibility and agility are achieved and measured by the speed at which units can receive and execute fragmentary orders. O/Cs have noted that units of Army XXI can expect to change and modify their task organization almost constantly during heated combat engagements.

Within this framework, the Army XXI combat organization will be quick to capitalize on the Engineer-Bradley Fighting Vehicle (E-BFV). The support provided by combat engineers has always been critical to success on the battlefield. With the loss of the fourth maneuver company in the heavy battalion, effective utilization of engineers, and the combat multipliers they bring, the new direct fire capability of the combat units must be closely examined. In an effort to capitalize on the addition of the E-BFV, the following defensive issues were addressed:

ISSUE 1: With only three maneuver company teams in a task force (45 platforms), should the supporting M2-based engineer company occupy a battle position (BP) during defensive operations?

DISCUSSION: An M2-based engineer company could potentially enhance the task force's direct fire combat power with nine M2s. Executing maneuver tasks, however, would result in a corresponding decrease in engineer tasks. The engineer force would require the necessary time to develop its engagement area (EA) and prepare to accomplish its maneuver task. This is time taken away from the obstacle effort. Additionally, engineer assets would not be available to provide mobility support to repositioning forces or to a counterattack force (strike force in a mobile defense). Even as the force relies more on the use of scatterable mine systems, engineer squads will still be decisively engaged in siting and marking these minefields and emplacing supplemental conventional minefields, construction, and demolition obstacles. When the event trigger for disengagement occurs in the forward area, engineer units need to continue to prepare the defense in depth or transition to the offense.

RECOMMENDATION:

1. The maneuver force commander with command over an engineer force must not assign the mission to occupy and defend a BP unless he is willing to accept the corresponding loss of engineer support. The decision to use engineers in this role must be made only after careful analysis of the commander's estimate.

2. Given that the engineer unit is in a command relationship, a technique is to have two-company teams each prepare an engineer platoon position as part of the company BP. This is done routinely when a company/team gives up a platoon to augment the security effort and is expected to receive the platoon back for the main defensive battle.

  • The company team sights and stakes in the engineer platoon's M2s as well as the dismounted weapons.

  • The company team marks all four corners of the vehicle fighting position with pickets and marks the friendly side of the picket on the driver's side with a chemical light for periods of low visibility.

  • The unit completes a range card to the standard described in Annex E of FM 23-1.

  • The engineer platoon needs to attend the company OPORD briefing and participate in the rehearsals.

3. Employ engineer support to the task force in direct-support (DS) role only. This prevents the task force commander from committing engineers to a BP if the engineer battalion needs them to weigh the effort/work in depth of sector.

* * *

ISSUE 2: How will an engineer company support a task force defensive operation?

DISCUSSION:

1. With increases in situational awareness, battlespace and the ability to execute precise operations, mobile defenses become the norm. During a mobile defense, engineers must support both the fixing force and the striking force.

a. Engineer tasks to support the fixing force include:

  • Emplacing obstacles (directed, situational and reserve) as part of engagement area (EA) development.

  • Constructing fighting positions for direct fire weapon systems.

  • Constructing survivability positions for critical assets such as C4I nodes, radars, and sensors.

b. Engineer tasks to support the striking force include:

  • Mobility support. The engineers form the breach force to mark bypasses (primary) or create a lane (secondary) in support of a company team's scheme of maneuver.

  • Countermobility support. The engineers emplace situational obstacles as part of a hasty EA development to integrate fires from a series of on-order ABFs or BPs.

2. Because of limited countermobility and survivability capabilities (few dismounts/two VOLCANOs and four M9s), the force requires echelon-above-division engineer support for a deliberate defense. The task force must allocate sufficient time to allow the engineer unit to prepare and rehearse with the striking force. The staff must develop an event trigger or decision point to disengage from support to the fixing force.

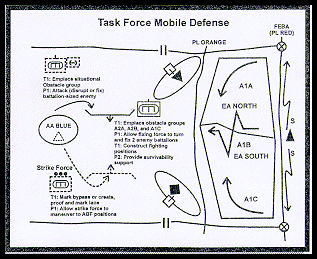

RECOMMENDATION: Figure 4-1 illustrates a way to provide engineer support to a task force mobile defense.

Figure 4-1

* * *

ISSUE 3: What is the impact of the FXXI engineer platoon design on conventional obstacle efforts?

DISCUSSION:

1. Given equal training, the FXXI engineer platoon productivity is reduced by more than one third from that of the larger AOE engineer platoon. There are two methods to improve the productivity of this platoon, or any platoon for that matter.

  • The first method is to augment the effort with non-engineer soldiers. This comes with an obvious cost, and the unit must develop drills to efficiently integrate this support.

  • The second method is to improve productivity by providing additional tools to the platoon. These include a mechanical marking system and the increased availability of scatterable mines such as mine canisters for the Volcano system.

2. While the increased reliance on scatterable systems makes sense given the resource intensiveness of conventional obstacle emplacement, the force should retain a conventional capability for several reasons:

  • Conventional effort may be the best solution in some situations (restrictive terrain).

  • The use of a wide variety of obstacles will complicate the enemy's breaching operations and require the enemy to have multiple reduction techniques to successfully reduce our obstacles.

  • The ROE may limit the use of obstacles to non-lethal options such as wire and other constructed obstacles.

  • It is much easier to reduce the size of the force if the need arises.

RECOMMENDATIONS:

1. Develop a mechanical marking device and increase the availability of Class V scatterable mines.

2. Retain the capability within the engineer force to emplace conventional minefields and constructed obstacles.

3. Develop improved conventional mines (full-width mines that do not have to be buried or are faster/easier to uncrate and prepare).

4. Develop a mechanical system for executing conventional mines.

* * *

ISSUE 4: How will the reduced number and size of engineer squads impact the row mining drill?

DISCUSSION:

1. The reduced number and size of engineer squads will require an adjustment to the row mining drill. The FXXI engineer platoon cannot task-organize into simultaneous siting and recording, marking, laying, and mine dump parties, which would require a total of 12-17 soldiers. The platoon must be augmented with non-engineer assets.

2. The alternative is to execute the tasks sequentially, at least partially, which has a negative impact of increasing the time duration.

RECOMMENDATIONS: The best solution is to develop two drills: one for an organic platoon and one for an engineer platoon with augmentation.

1. Drill 1 (Organic Engineer Platoon): The platoon leader task-organizes the platoon into the following parties:

  • Siting and recording
  • Marking
  • Mine dump
  • Laying

a. The platoon leader and one squad participate in the mini-rehearsal to site in the obstacle group during the EA development drill. The overwatching maneuver unit provides the "enemy" vehicles required to replicate the enemy force.

  • Once the siting party marks the obstacle group trace, the squad begins emplacement of the perimeter fence while the platoon leader and two-three soldiers lay out each minefield. This crew also marks the centerline (scatterable) or required markings for all other obstacles in the group.

  • Four-sided fences are the standard, beginning with the enemy side, then the sides, and finally the friendly side. One squad uses an M2 or other cargo vehicle to drop wire and pickets off along the fence line. The dismounts then pound the pickets and string the wire.

  • After all the wire and pickets are laid on the ground, the M2 can go back to the mine dump or Class IV/V point to get more materials while the dismounts install the perimeter fence.

  • An opening must be left at both sides of the minefield at the friendly end to allow one way traffic flow of all vehicles inside the minefield. This method resembles the same techniques used with HEMMT support.

b. The platoon sergeant and the other squad perform the functions of the mine dump party at the mine dump (service station) as the mines are transferred from a transport asset to the emplacing vehicle (tail gate). If necessary, the mine dump is done at the Class IV/V point (supply point).

  • These functions include loosening and greasing fuse and booster wells and ensuring proper functioning of the mine.

  • The team transloads a mine strip onto each laying party's emplacing vehicle or a mine-delivery system.

  • In a M2, an entire turn/block row of M21 mines can be placed on the floor if laid on the side and not fused. M15 and Ml9 mines could probably also be laid on their side, although this has not been tested.

  • If necessary, a single M2 will hold enough mines inside for a complete fix/disrupt minefield, if mines are stacked sideways and two deep. On the sides of the Bradley, with the side handle modification, the Bradley can carry around 30 pickets outside, in addition to the 15 rolls of wire on deployed trim van. If the side handles are not modified, the section leader Bradley can carry the pickets inside the troop compartment.

c. Once the mines are prepared and uploaded, the platoon sergeant and squad proceed to the minefield site. This squad now functions as the laying party under the supervision of the platoon sergeant.

  • At the start row marker, the carrier team moves into position and prepares to lay mines. The sapper team ties a rope to the end of the lowered ramp or the tow pintle, and ties a partially filled sandbag to the other end of the rope. The rope length from the end of the ramp door to the sandbag is the correct spacing between mines.

  • The mine-laying squad has Soldier 1 sitting at the rear door seat, taking mines one by one from the floor and handing them to Soldier 2 walking behind the Bradley. When the last mine on the ground reaches the end of the 6-meter rope, the next mine goes down in the proper place.

  • The Bradley Commander (BC) (Squad leader) ensures that the driver is maintaining a correct azimuth (usually only required for novice drivers or hours of darkness when the intermediate markers and end row markers cannot be seen).

  • For buried mine rows, the dismounts make a second pass digging in the mines after the row has been laid.

  • Soldier 3 travels behind the mine-laying vehicle, fusing the mines and preparing the mine for arming (i.e., exact placement, placing tilt rod next to the mine).

  • The team leader on the ground is supervising the actions of the dismounts. He removes the temporary markers installed by the siting and recording party and replaces the end row markers with permanent markers, completes the strip feeder report (refer to Figure 6-6 of FM 20-32), and arms and buries the mines.

d. While at the minefield site, section leader vehicles will take up overwatch positions on the minefield site, where the leaders dismount to check on the status or inspect the emplacement. Their M2s can also be used to carry mines and pickets in the rear of the vehicle. Because of the plow on the front, section leader M2s do not have trim-vanes; therefore, they can carry only the amount of wire they can strap on the side. The driver and gunner of those two vehicles should not dismount unless there is an emergency.

e. Once the rows have been laid and the minefield NCOIC is satisfied that the requirements in FM 20-32 have been met, the fence is closed and DA Form 1355 is completed and sent to higher level.

2. Drill 2 (with Non-Engineer Augmentation): The engineer platoon with supporting soldiers task-organizes as described in the table below.

Task Organization of an Augmented Engineer Platoon

Task OrganizationOfficerNCOEMEquipment
Siting and Recording Party

(Engineer/non-engineer)


1/0 2-3/0

SITEMP, maneuver and fire support graphics, obstacle overlay, execution matrix, GPS, lensatic compass, minefield record forms, stakes, cones, or pickets, picket pounder, engineer tape on reels, and nails to peg tape (Note 1).
Marking Party 1/00/6-8Barbed wire or concertina, marking signs, lane signs, wire cutters, gloves, picket pounder and pickets (Note 2).
Mine Dump Party 1/02/4-6Wire cutters, grease, rags, gloves, NVDs, and pliers (Note 3).
Laying Party (Note 4) 1/0 Strip feeder reports.
Carrier Team 2/0Vehicle.
Sapper Team 11-3/1Wrenches, fuses, row markers.
Digging Team 0/1-2Picks, shovels, and sand bags
Total (Note 4)1/04/07-10/
12-17

NOTES:

1. The use of the mini-rehearsal to site an obstacle group during EA development may initially require all of the engineer platoon vehicles to portray the enemy's maneuver through the EA. An alternate solution is to use the engineer platoon leader, maneuver company team 1SG, and other maneuver team headquarter's vehicles.

2. Minefield marking is time and labor intensive. Any available soldiers should be placed on this team, especially when marking scatterable minefields.

3. If the unit uses the supply point or tailgate resupply technique, the unit must task-organize to do the mine dump tasks at the Class IV/V point or at the point where the mines are transferred to the emplacing vehicle. See Table 2-2 and Table 2-7, FM 20-32, for additional mine dump and Class IV/V supply point planning factors.

4. The unit may employ one or more laying parties. Each laying party emplaces one row of mines at a time.

5. Organization may vary depending on terrain, soldiers, and material available and proximity of the enemy. This typically requires augmentation by non-engineer soldiers. Non-engineer soldiers can be integrated into any of the parties, but it is simplest to integrate them into the marking and mine dump parties in squad-size units, or as individuals into the digging team.

a. The siting and recording party moves with the "enemy force" during the mini-rehearsal to mark the trace of the group or individual obstacles. The siting and recording party then selects the landmarks, and marks the start, intermediate control, and end row markers for each row, or the center line for scatterable minefields. If available, the marking party begins to emplace the fence.

b. At the same time (or if possible, in advance) the mine dump party task-organizes the minefield packages into mine-strip packages (complete with the right number, type, and mix of fuses and boosters). They prepare the mines for emplacement, but they do not fuse the mines at the mine dump. Preparation includes loosening and greasing fuse and booster wells and ensuring proper functioning of the mine. The team transloads a mine strip onto each laying party's emplacing vehicle or a mine-delivery system.

c. The laying party proceeds to their assigned row.

  • At the start row marker, the carrier team moves into position and prepares to lay mines.

  • The sapper team ties a rope to the end of the lowered ramp or the tow pintle, and ties a partially filled sandbag to the other end of the rope. The rope length from the end of the ramp door to the sandbag is the correct spacing between mines.

    • Soldier 1 is at the rear of the squad vehicle.
    • Soldier 2 sits on the edge of the ramp or open door.
    • Soldier 3 walks behind the carrier.

  • Soldier 1 fuses a mine and passes it to Soldier 2.

  • Soldier 2 records all the mines issued.

  • Soldier 3 places the fused mines on the ground when the sandbag tied to the rope is even with the previously laid mine.

  • The laying party NCO walks behind the vehicle and supervises mine laying. He removes the temporary markers installed by the siting and recording party and replaces the end row markers with permanent markers. He also completes the strip feeder report (again, refer to Figure 6-6 of FM 20-32).

  • Soldier 4 walks behind the vehicle, and arms and buries the mines.

  • The procedure is repeated for each row. If more than one laying party is employed, the second laying party begins once the first party has moved a safe distance (approximately 25 meters) along its row.

d. The marking party completes the rear boundary fence, and the recording party completes DA Form 1355.

* * *

ISSUE 5: FXXI units rely heavily on executing their countermobility tasks with scatterable mine systems. When should the engineer battalion consolidate the battalion's ground Volcano assets?

DISCUSSION: With the reduced number of blade assets and engineer soldiers, the engineer battalion's six ground Volcano systems are the focus for execution of counter-mobility tasks. With only one load, the battalion can emplace nearly 7 kms of minefields (6,600 x 120 meters) in 20 minutes. Leaders may desire to centrally control these assets by creating an ad-hoc Volcano platoon at the battalion level. However, during many missions, the dispersion and number of targets require decentralized execution which negates the advantages of using a battalion-level organization. Planning, preparing, and executing Volcano missions in support of task force maneuver is actually hindered by the centralized control. Control at the engineer battalion level requires that the battalion issue a complete OPORD to the Volcano subunit. It also becomes necessary for the engineer battalion to logistically support this separate unit to include LOGPAC and CASEVAC support. However, the engineer battalion commander is not normally responsible for the AO in which the targets are located nor does he have control of the overwatching maneuver force and the observer assets to monitor NAIs and TAIs. This leads to difficulties in integrating fires with obstacles, and ensuring the area is clear before execution. For most brigade missions, it is not possible for a single platoon-sized element (Volcano team) to emplace Volcanos throughout the width and depth of the brigade AO.

RECOMMENDATION: Task-organize Volcano assets using the following considerations:

1. Determine maintenance status, loads available, and location of all systems during EBA.

2. Integrate employment of Volcanos into each maneuver course of action (scheme of scatterable obstacles).

3. If employed to support task force maneuver, task-organize to task force.

4. If employed to support brigade maneuver but executed within only one task force's AO, task-organize to that task force. Brigade order must direct the execution of the obstacles as well as direct the task force to disrupt, fix, turn or block an enemy force at a designated location through the use of assigned BPs, SBF/ABFs, and EAs. In other words, the brigade must be no more or less directive with obstacle than it is with maneuver tasks.

5. When the desired effect requires multiple Volcano minefields, within a single EA (may support more than one possible EA) overwatched by a brigade-level maneuver force (for example, the brigade reserve), consider task-organizing the Volcano systems with engineer leadership to the brigade-level maneuver force.

6. Synchronize the Volcano plan during COA analysis (war gaming). For Volcanos employed as situational obstacles, the timing for Volcano movement and emplacement, and maneuver force fires integration with a corresponding observer plan must be determined during this MDMP step.

7. Conduct mini-rehearsal to site all Volcano targets as part of the EA development drill with the overwatching maneuver force.

8. Complete PCCs/PCIs early to include communications systems.

9. Conduct rehearsals at all levels. Rehearse timing requirements to include the decision cycle and SCATMINWARNs and SCATMINRECs. Review Volcano plan during all combined arms rehearsals.

10. Battle-track preparation from CL V upload to marking the centerline to DPs/triggers to actual execution.

* * *

ISSUE 6: How does the FXXI engineer battalion conduct security operations without dedicated reconnaissance assets?

DISCUSSION: Creating a reconnaissance element out of organic assets or providing engineer soldier to other reconnaissance units, such as the brigade reconnaissance troop, will further degrade the battalion's ability to execute mobility and countermobility tasks due to the limited number of sappers in the platoon. Furthermore, as the engineer commander is not normally responsible for an AO, the use of ad-hoc engineer reconnaissance element requires extensive operational and logistical coordination. The engineer leader must base his decision to support the reconnaissance effort on a prioritized list of engineer-essential tasks for the given mission. If reconnaissance is an essential task, then the leader develops a plan to execute the mission.

RECOMMENDATION: Support the reconnaissance effort based on the following considerations:

1. If reconnaissance is identified as an essential task during mission analysis, integrate it into the brigade combat team or task force R&S plan.

2. Support with an organic element (squad or platoon).

3. Focus on OBSTINTEL (tactical) or required engineer technical data.

4. Know that the "chief of reconnaissance" for the AO command-controls the engineer reconnaissance element (squad or platoon).
